BOYNTON BEACH • S14635-01

31AUG
Chassis Prep

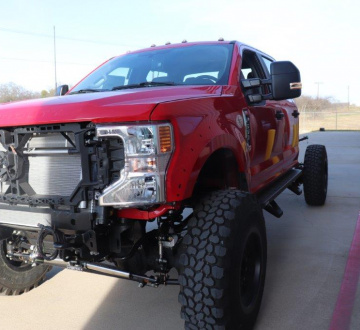

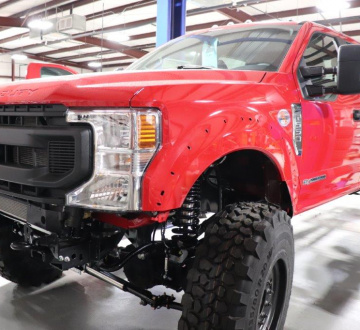

The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

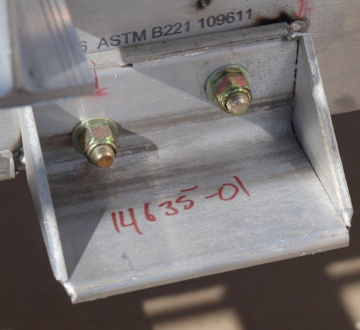

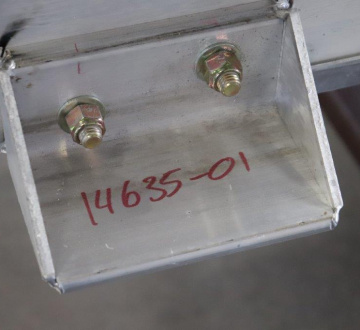

02SEP
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

02NOV
Fabrication

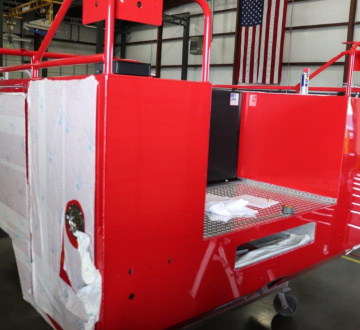

The frame will be constructed, the compartments are fabricated and the body will be assembled.

04NOV
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

09NOV
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

16NOV
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

18NOV
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

23NOV
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

30NOV
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

02DEC
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

07DEC
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

07DEC
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

09DEC
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

09DEC
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

16DEC
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

23DEC
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

01FEB
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

01FEB
Fabrication
The frame will be constructed, the compartments are fabricated and the body will be assembled.

09FEB
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.

09FEB
Electrical

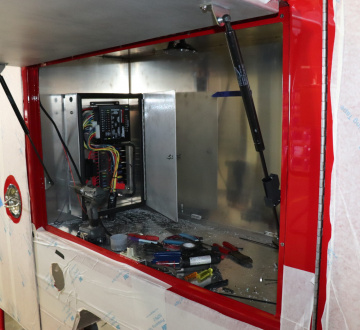

The wiring harness is installed. Emergency and scene lighting are mounted and terminated at the breaker panel.

22FEB
Chassis Prep
The bumper is replaced, cab consoles are fitted and the suspension upgrade package and tires are installed.


25FEB
Assembly

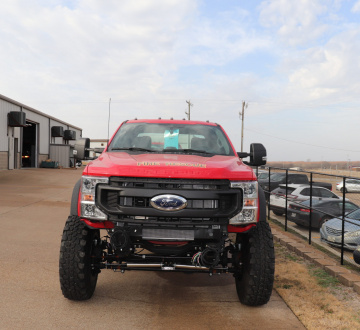

The body will be mounted to the chassis, final plumbing and electrical connections are made.

07MAR
Assembly
The body will be mounted to the chassis, final plumbing and electrical connections are made.

09MAR
Assembly
The body will be mounted to the chassis, final plumbing and electrical connections are made.
